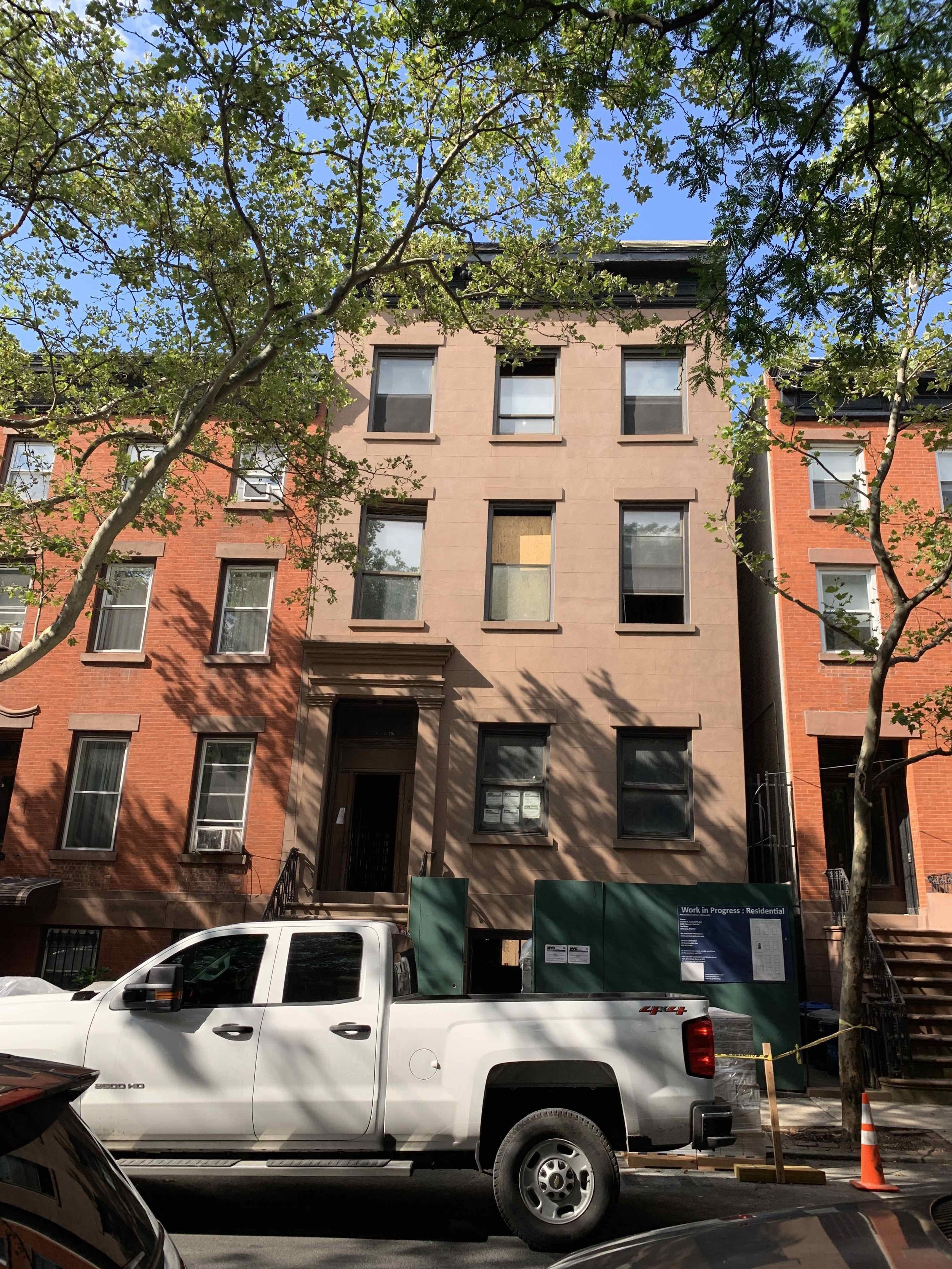

Update on 279 Sackett St

June 19, 2019

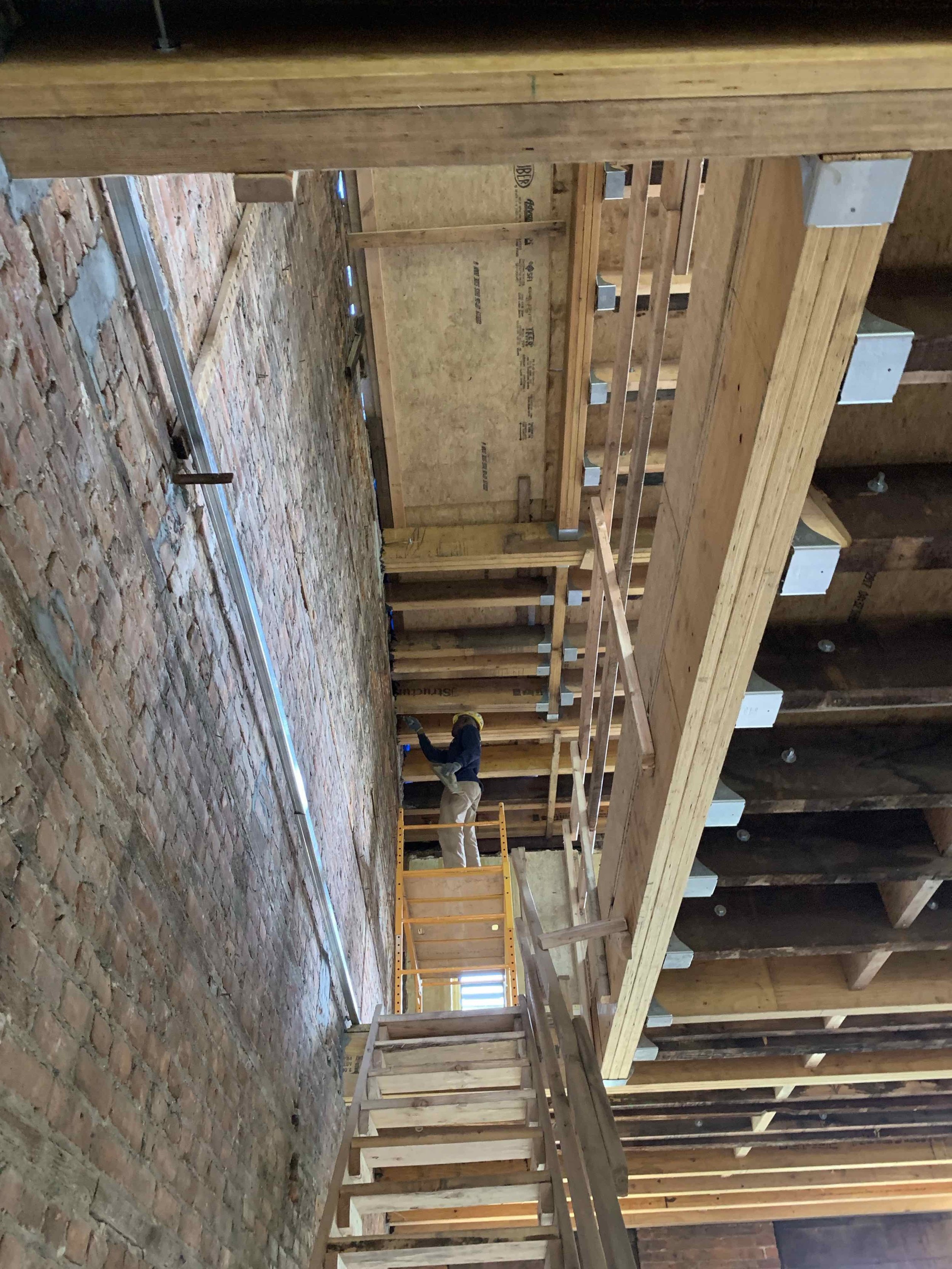

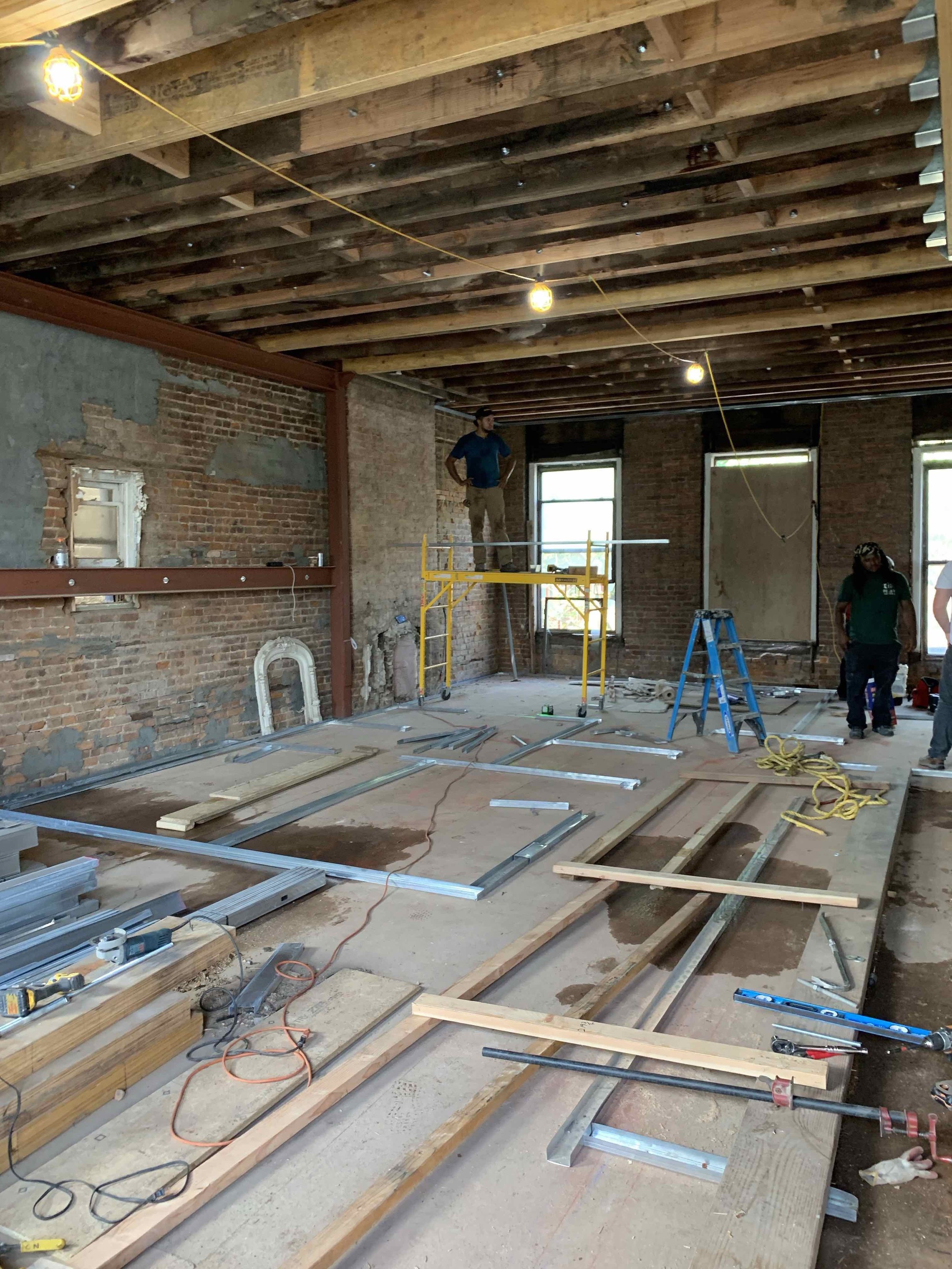

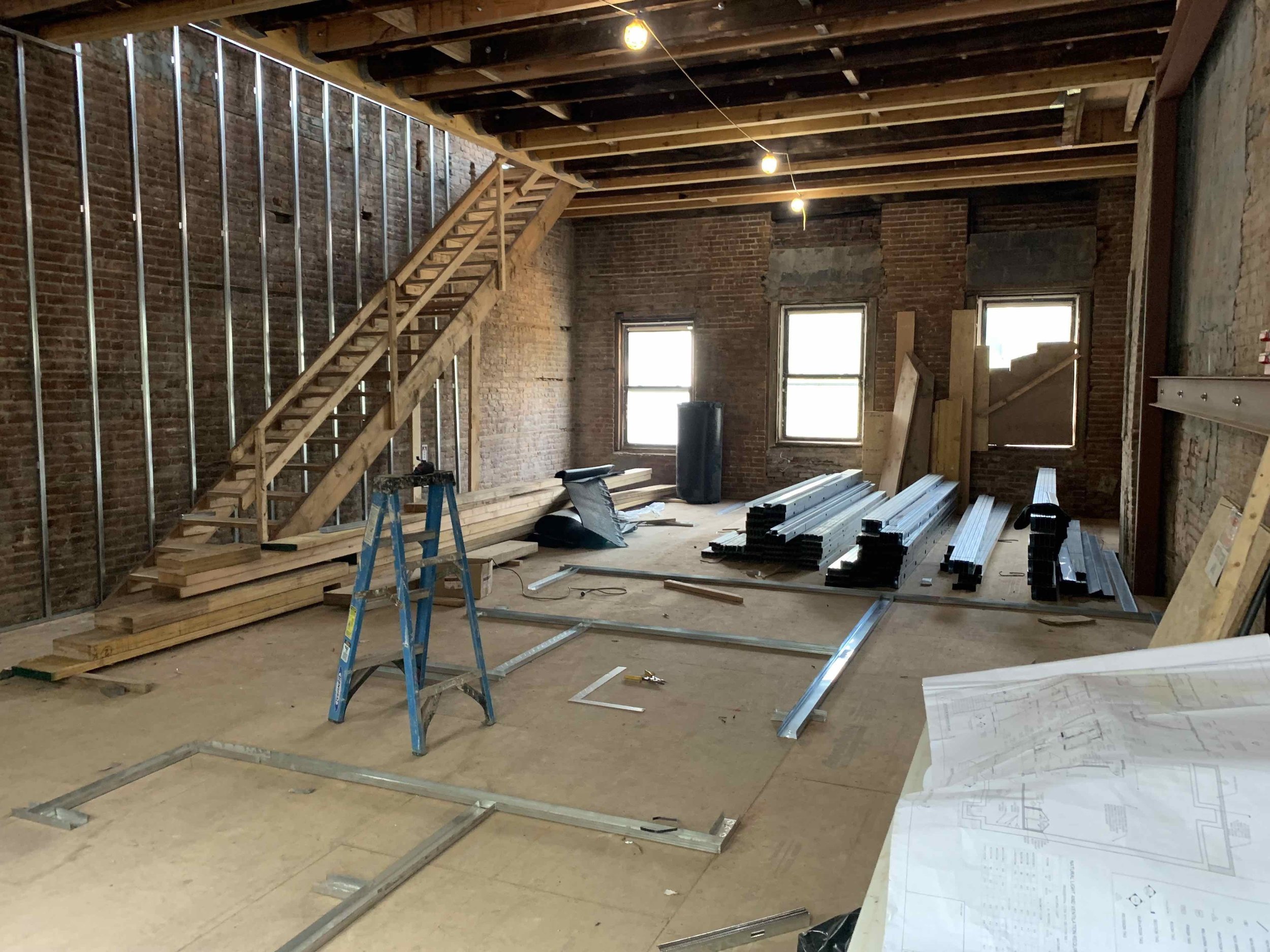

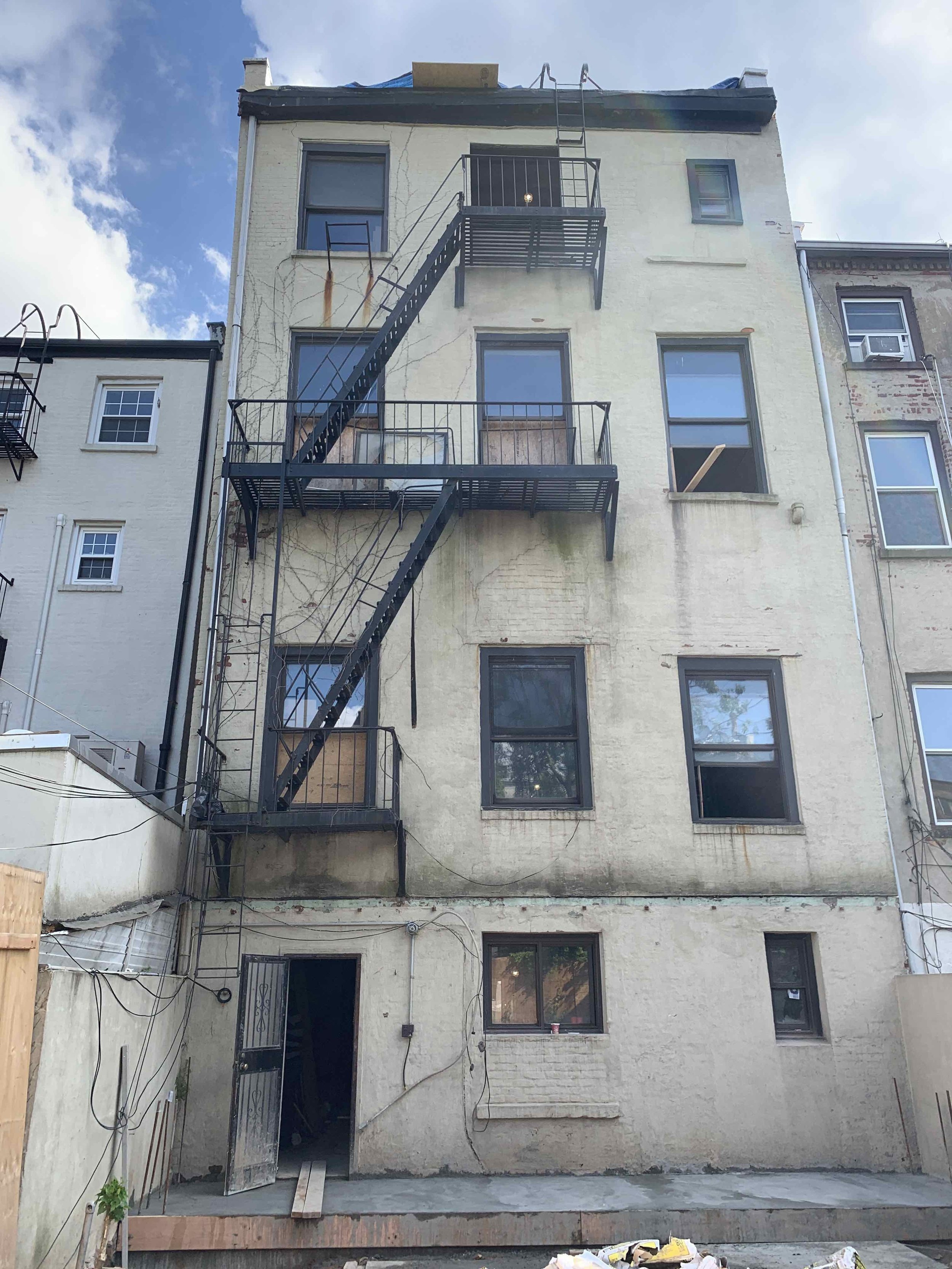

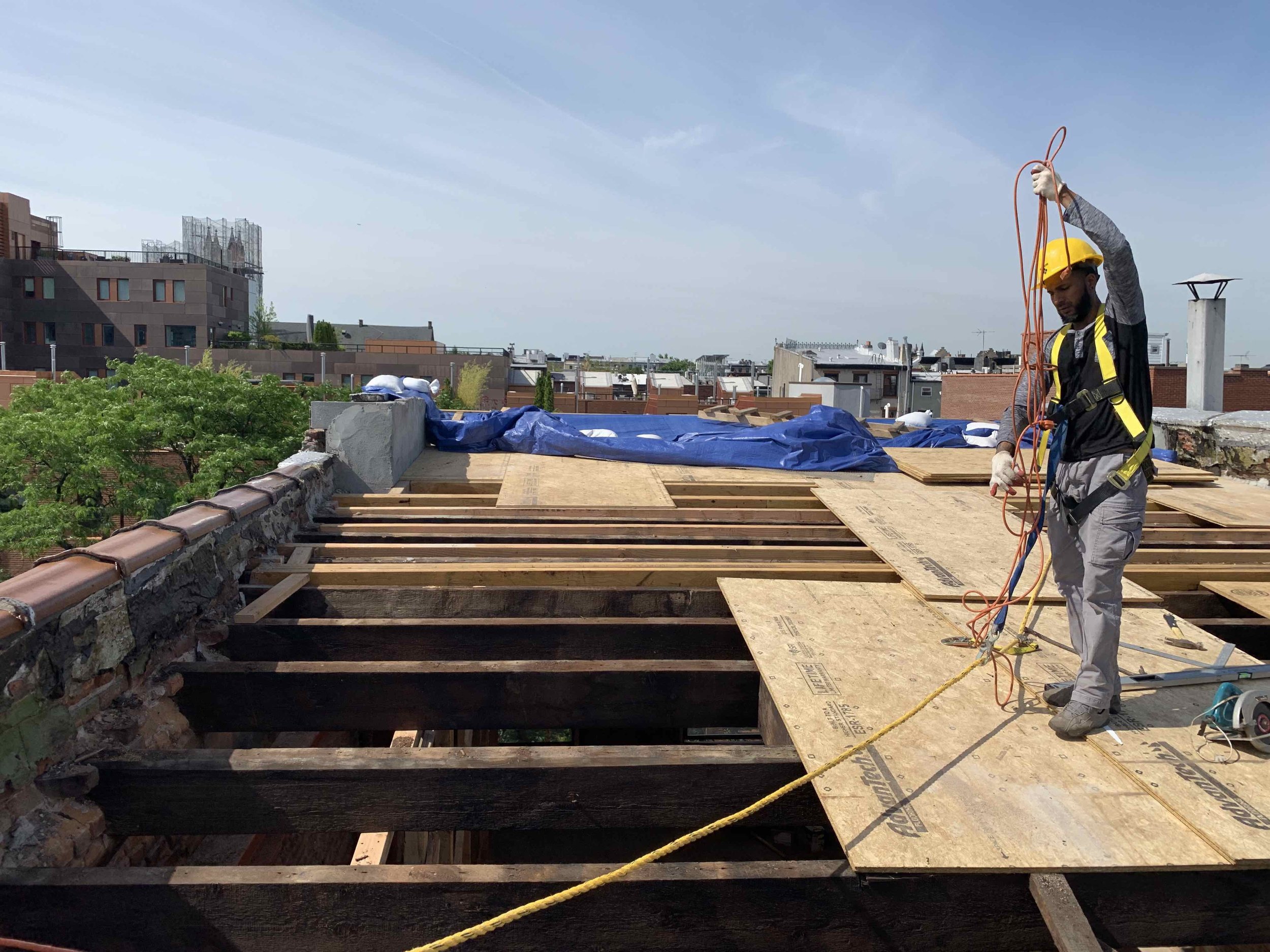

At 279 Sackett Street, the installation of the new roof and all structural work to existing building were completed as of Monday 6/17.

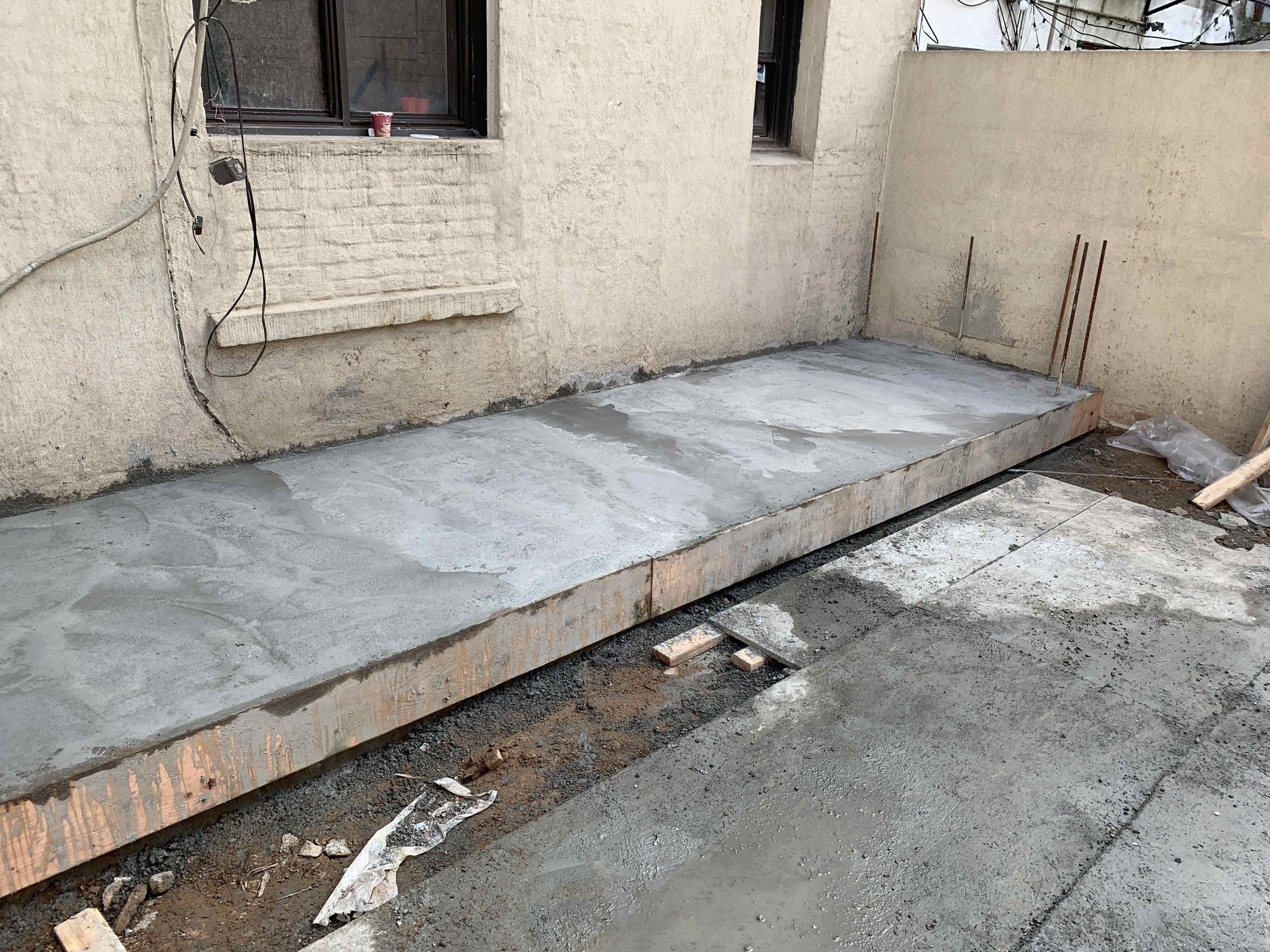

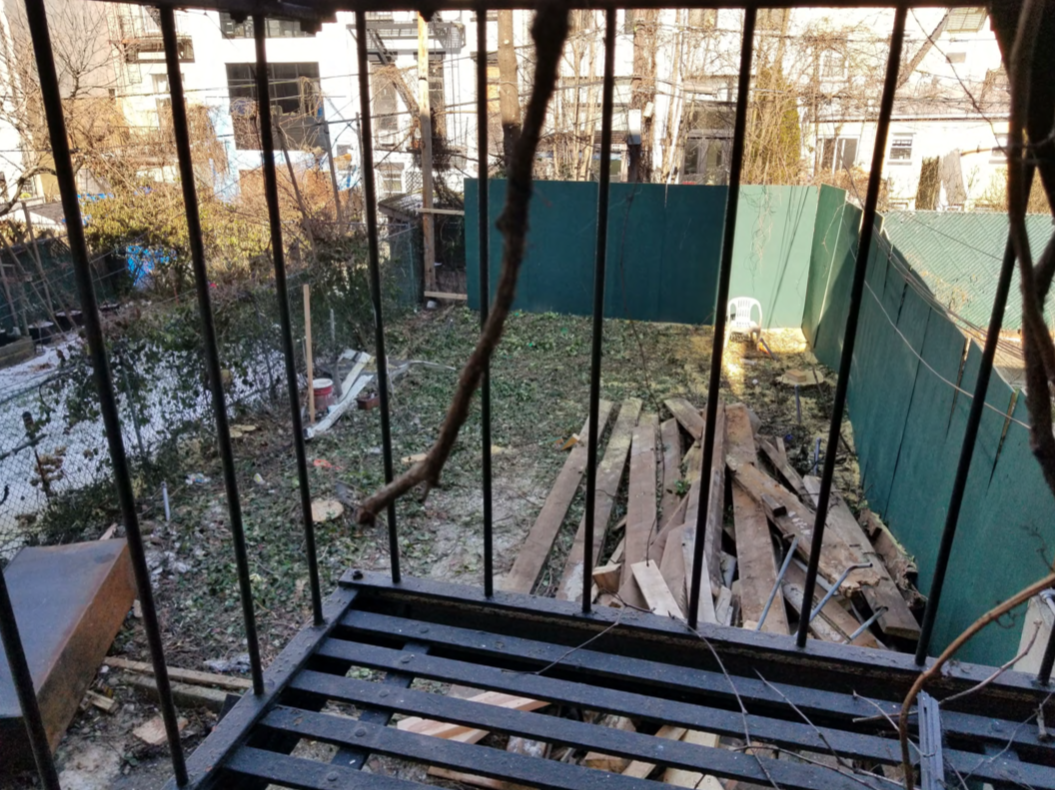

We will start demolishing the exterior rear patio and dig for extension footings soon after.

279 Sacket June19-07.jpeg

May 13, 2019

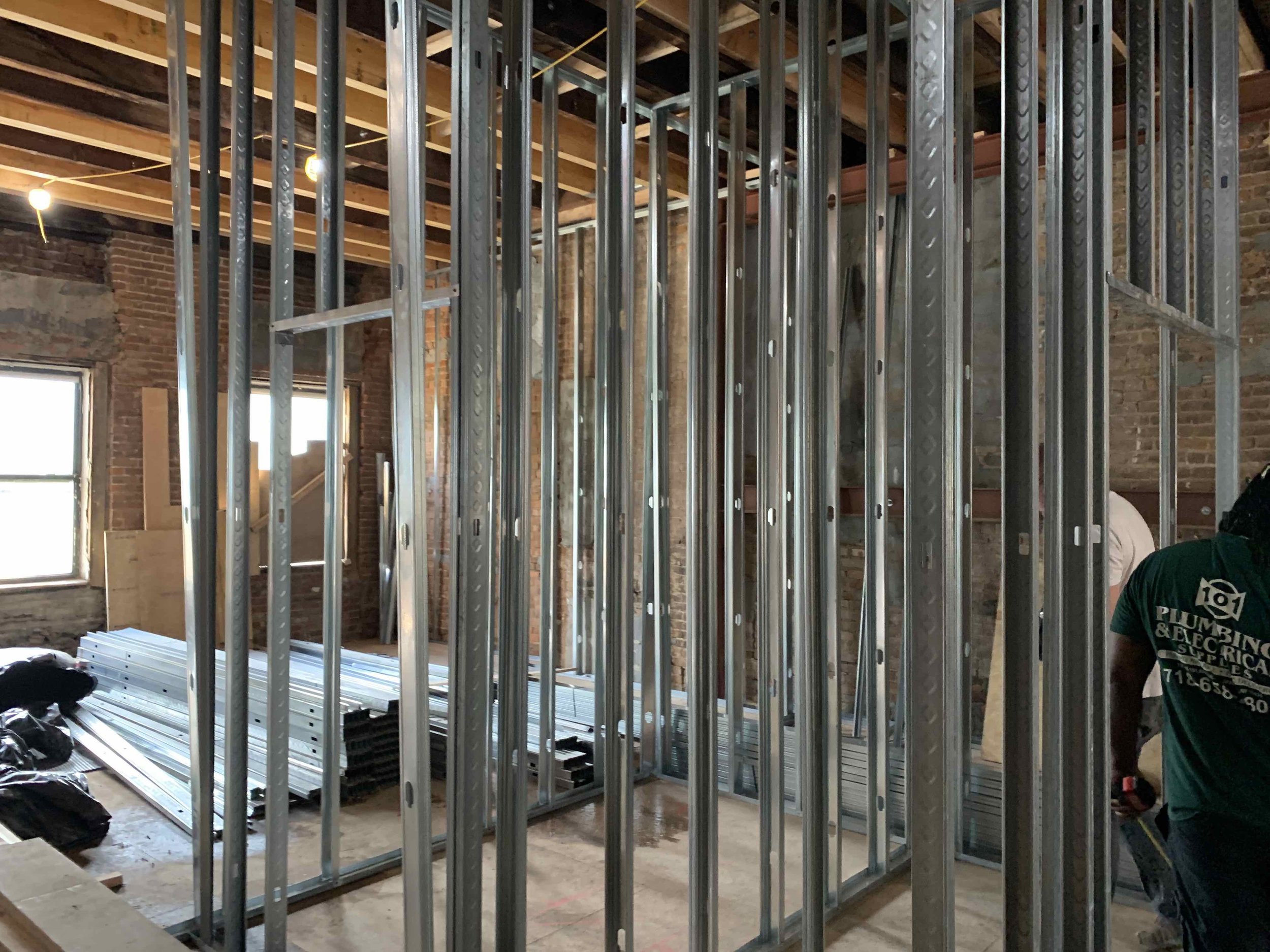

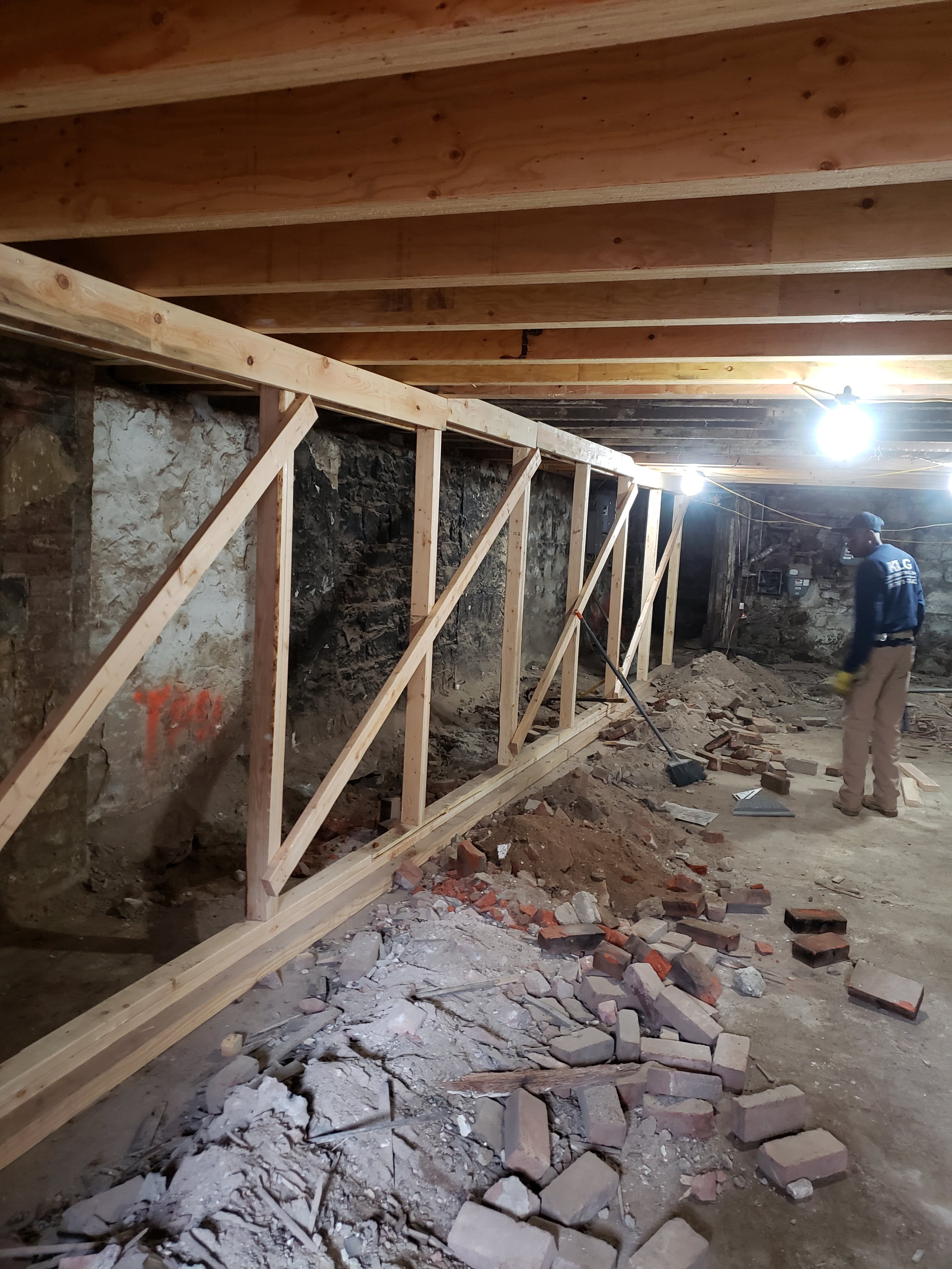

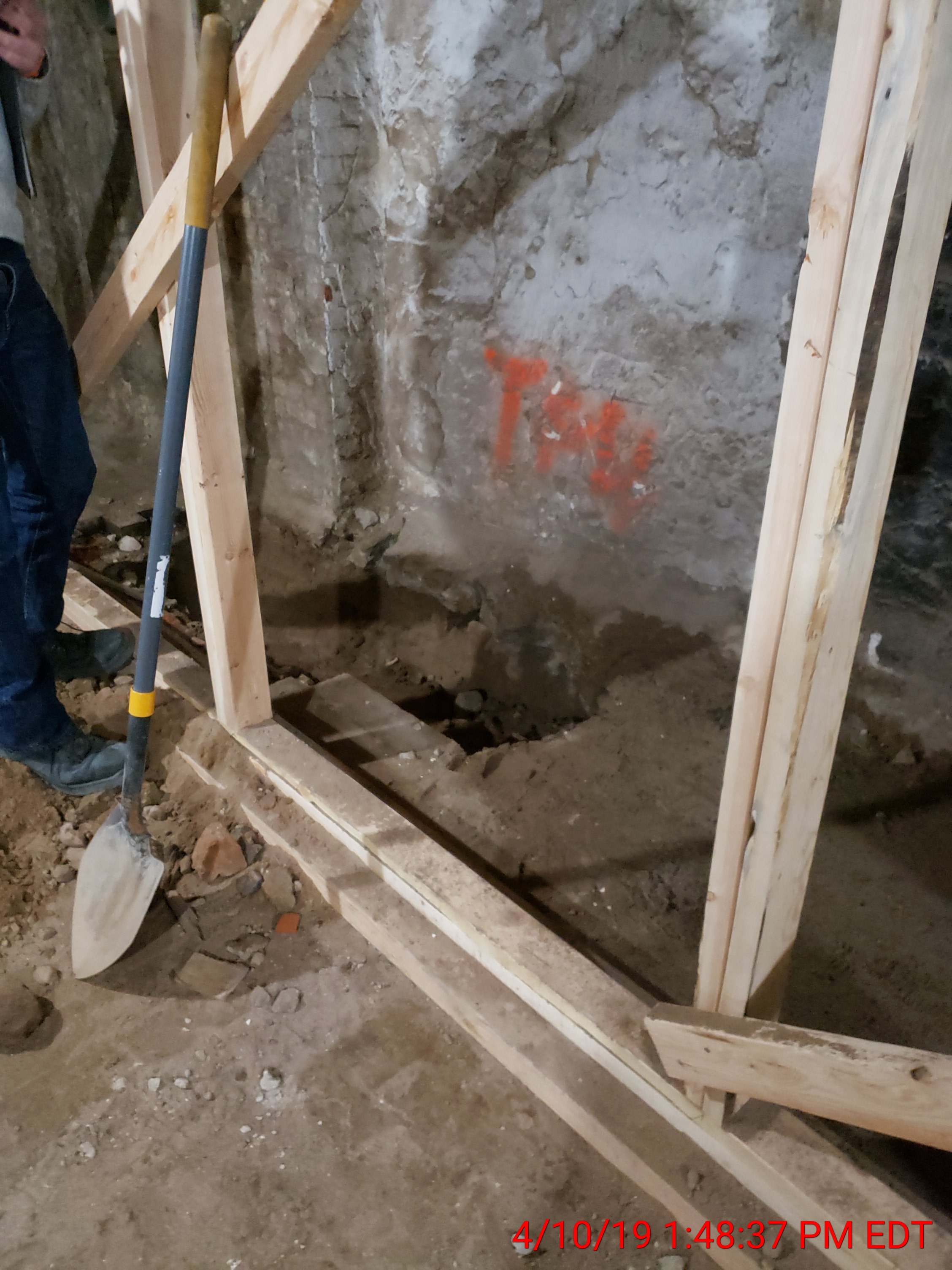

Structural reinforcement is being done to existing party wall this week, followed by structural steel installation starting next week.

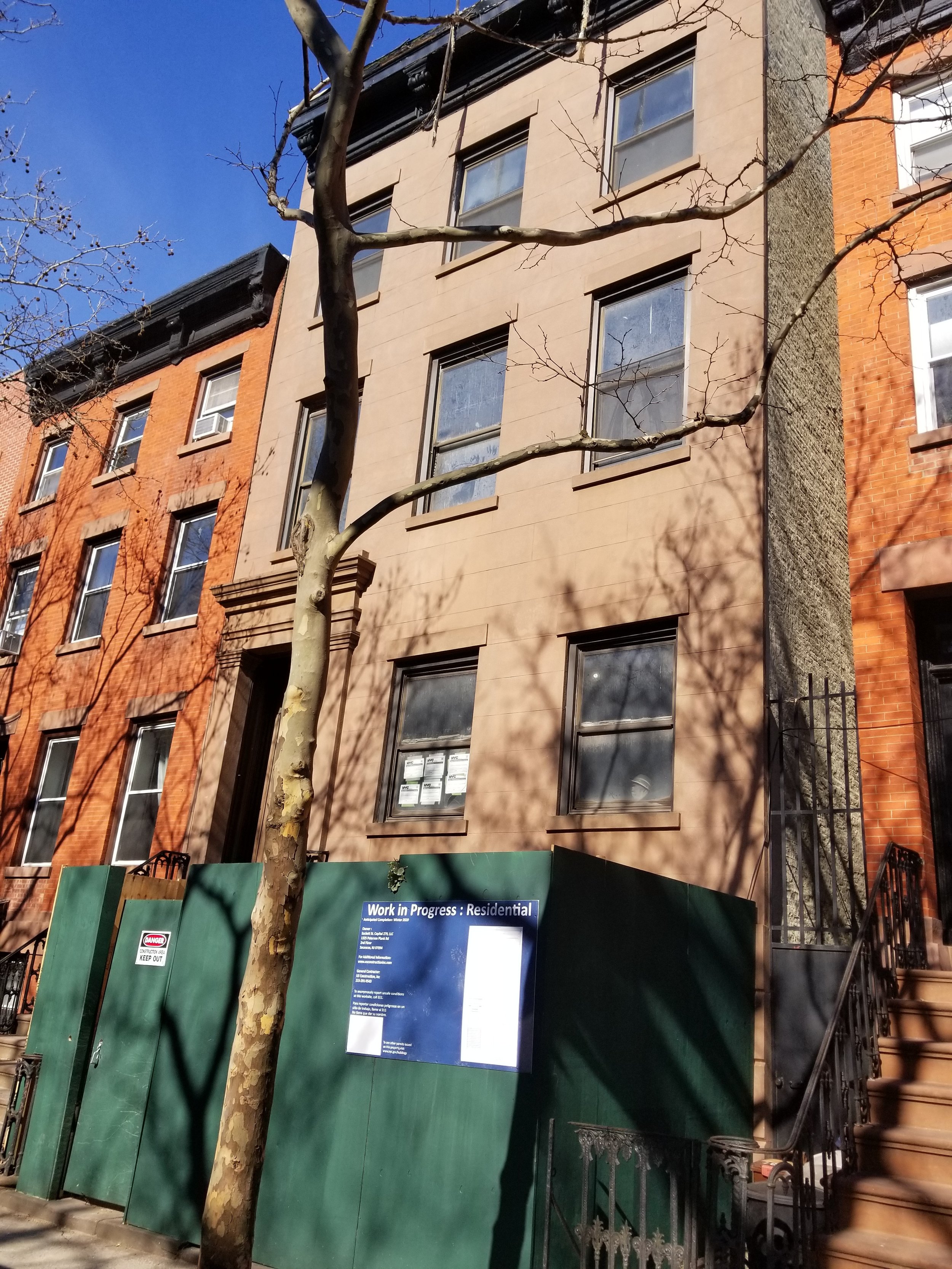

May 2, 2019

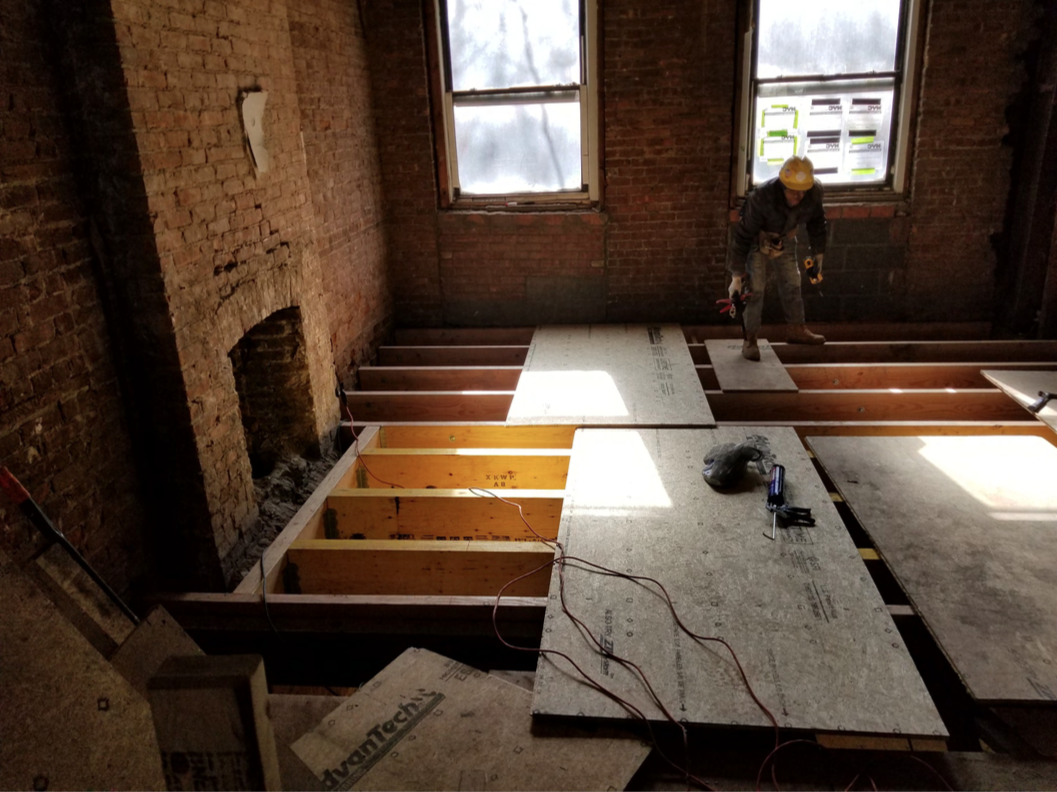

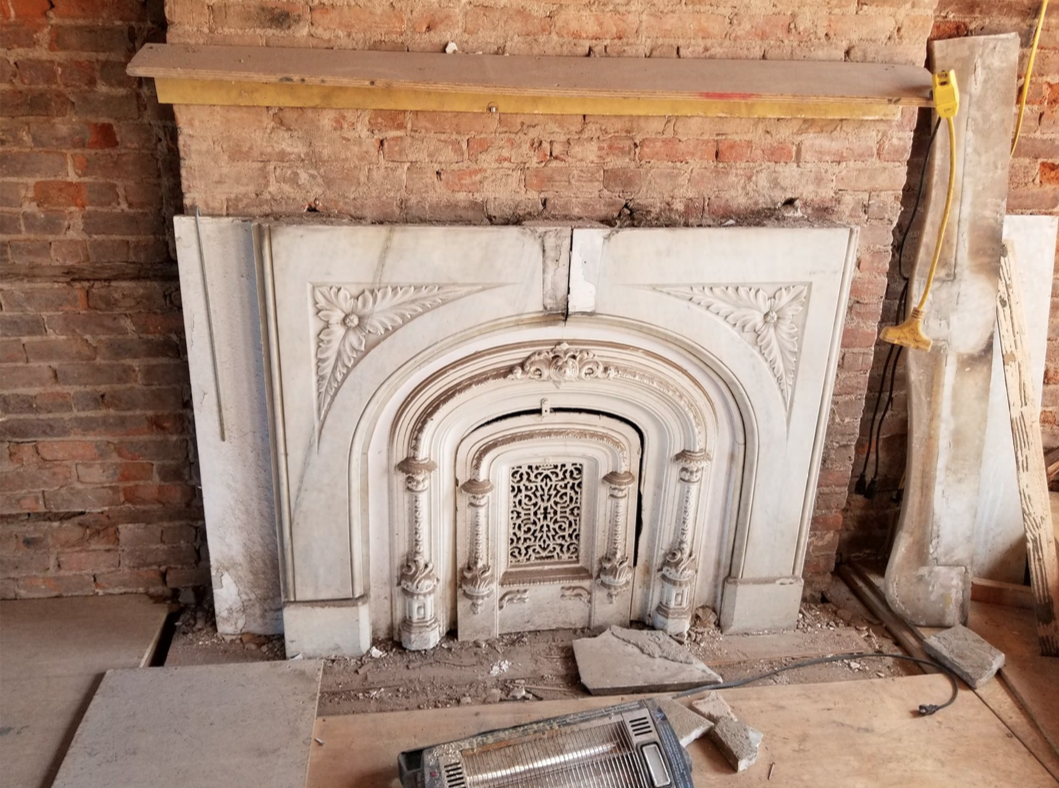

Work is progressing nicely at 279 Sackett Street!

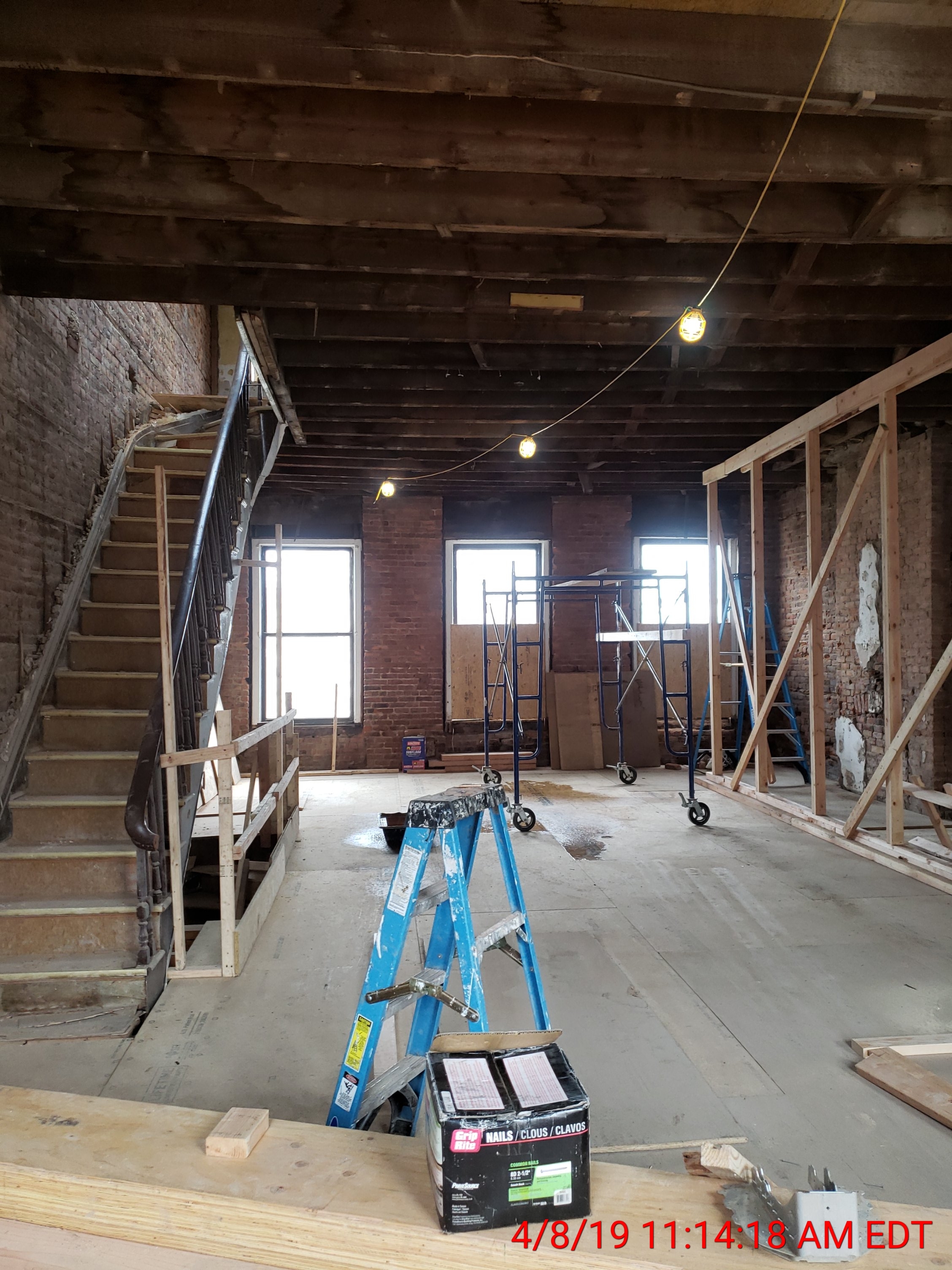

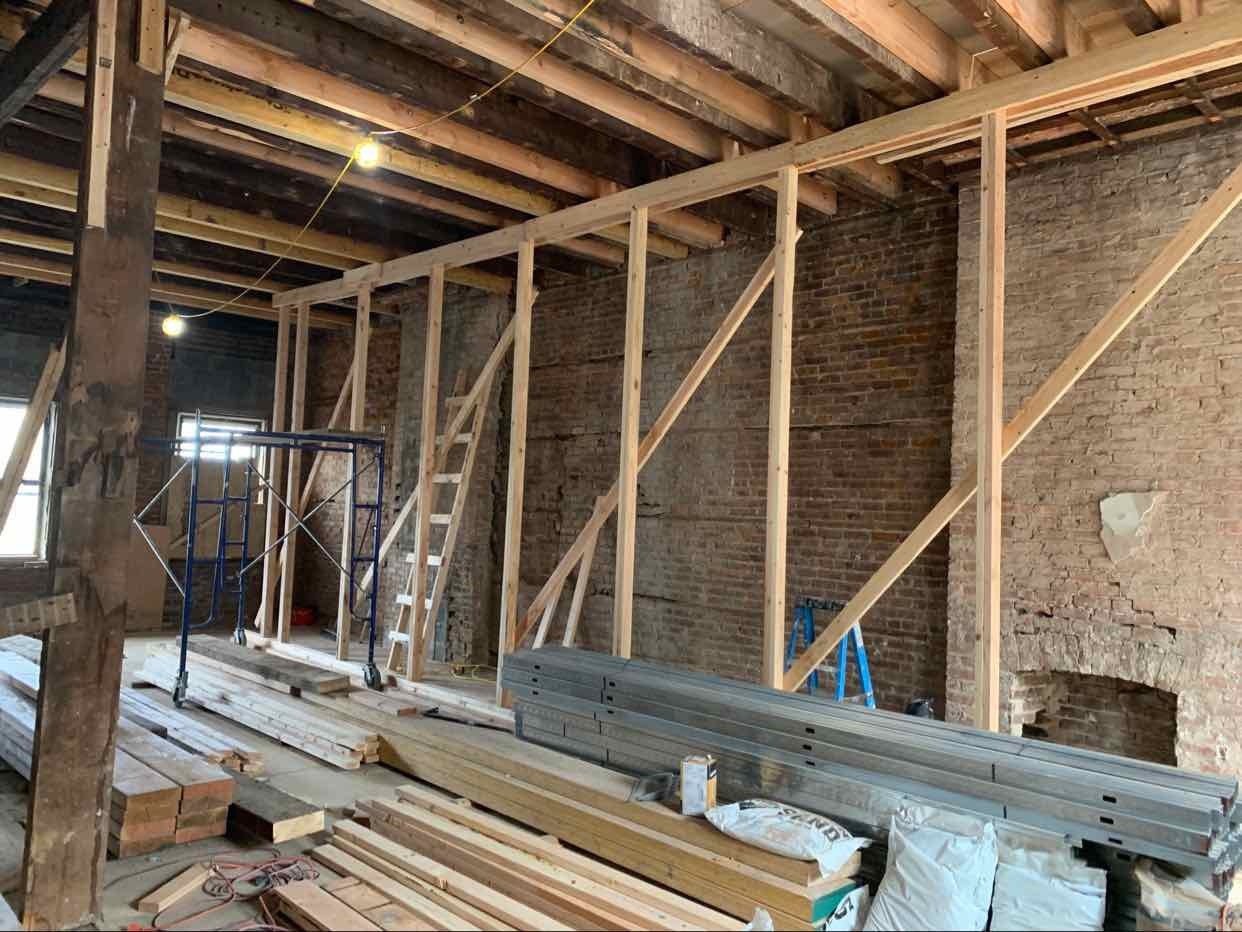

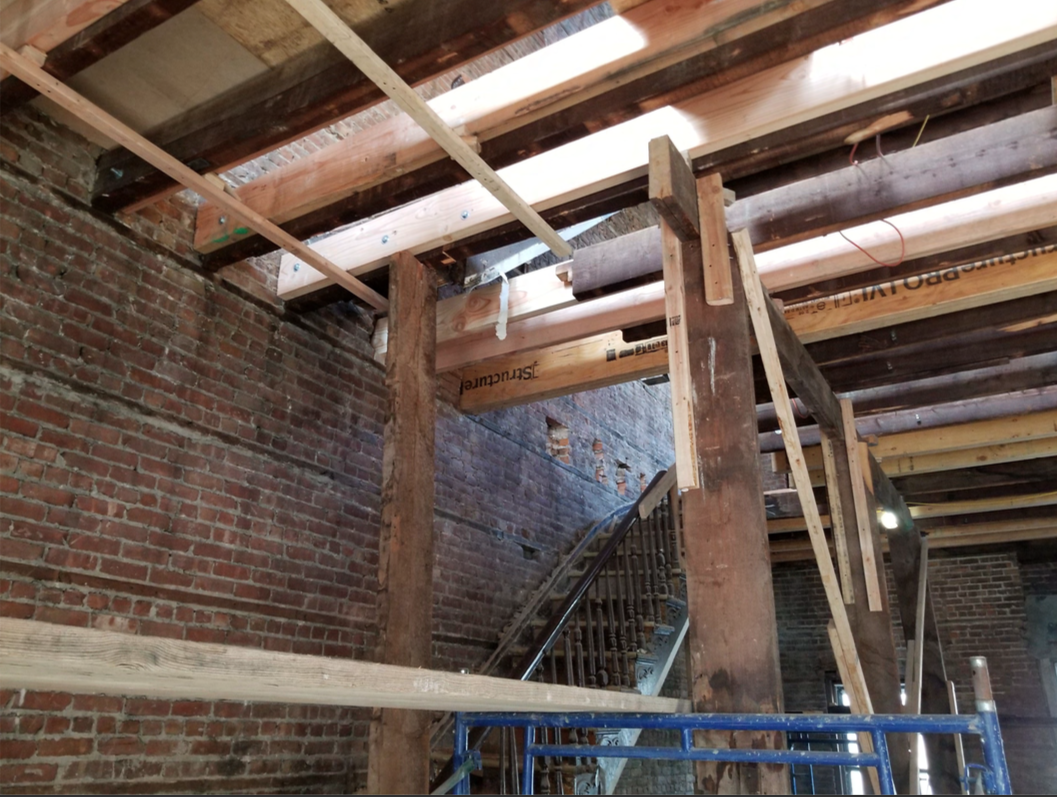

Structural Beam Work is on track to finish by mid-April.

March 19, 2019

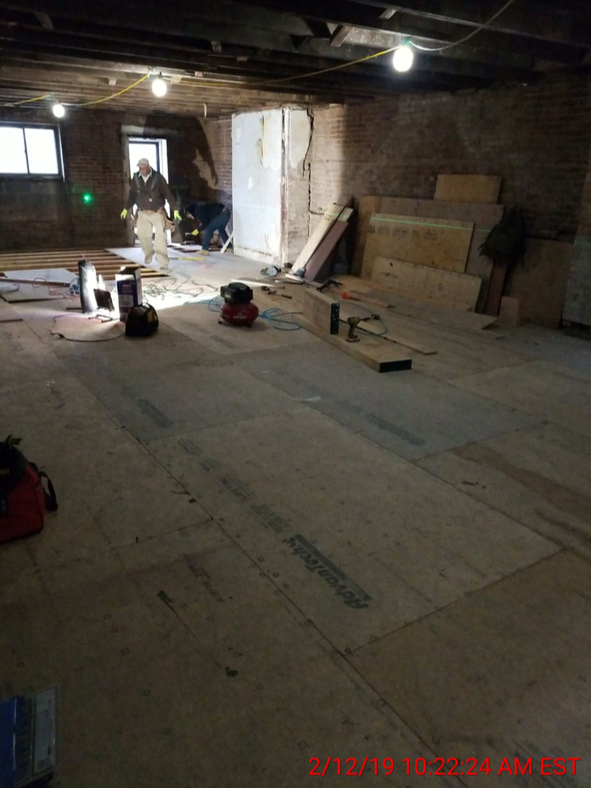

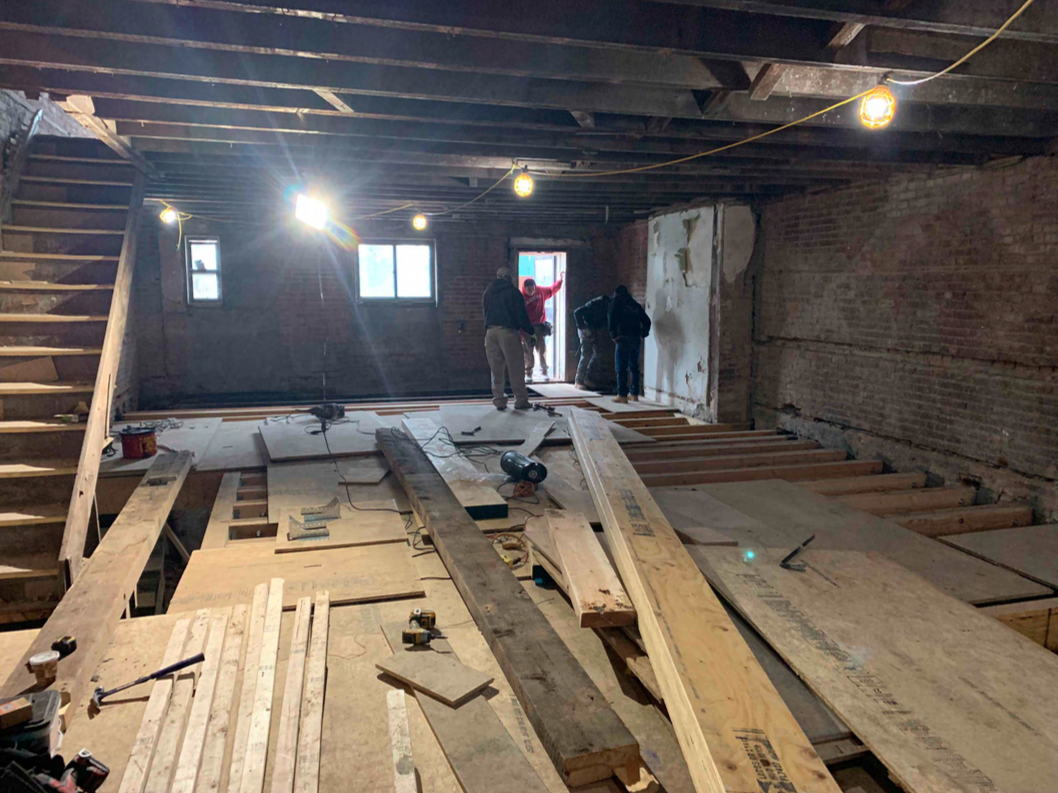

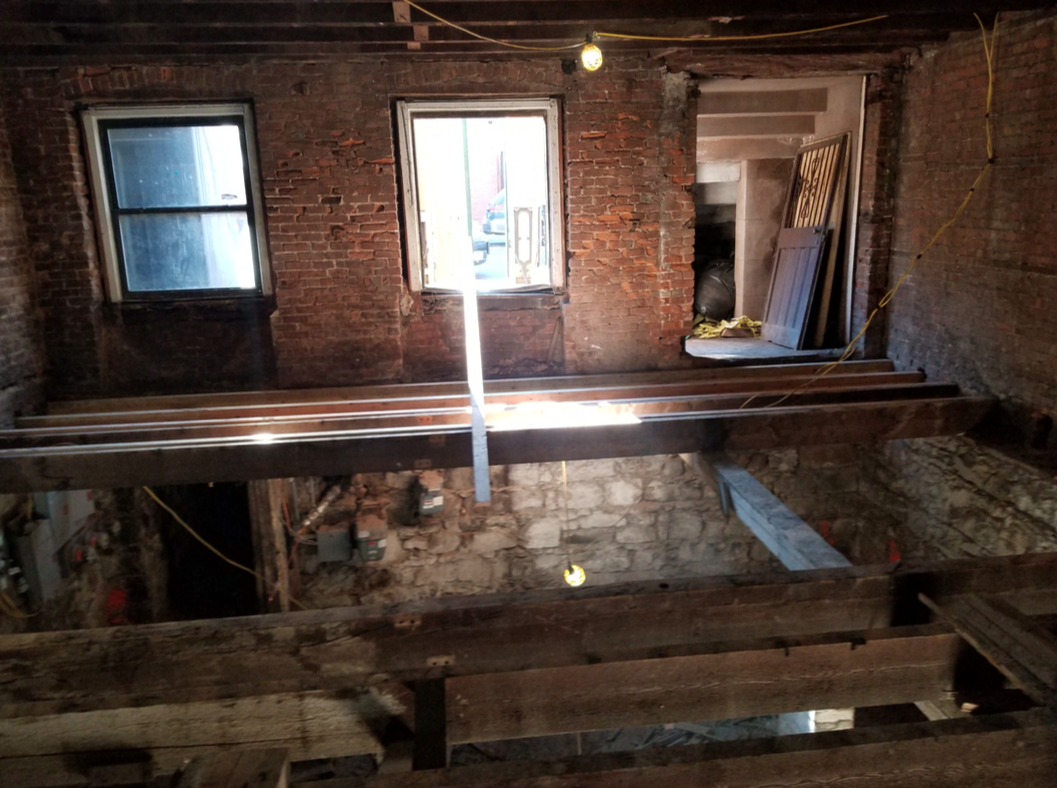

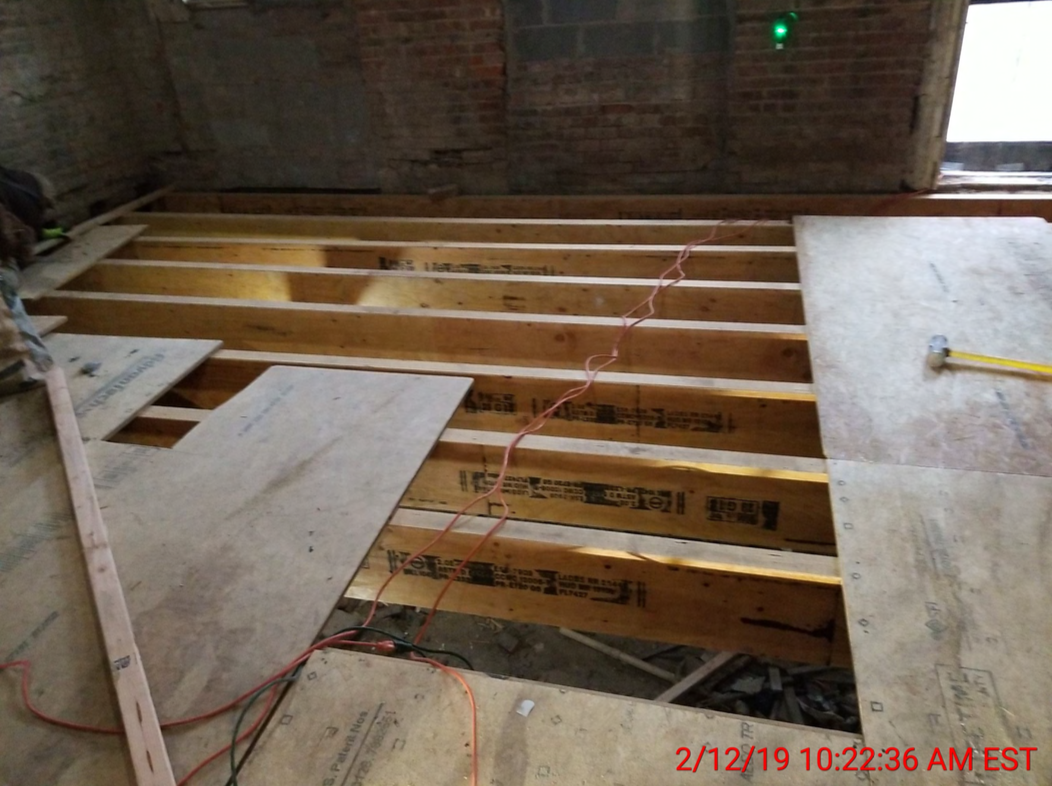

We are officially finished with “sistering” all existing joists at 279 Sackett Street!

January 4, 2019

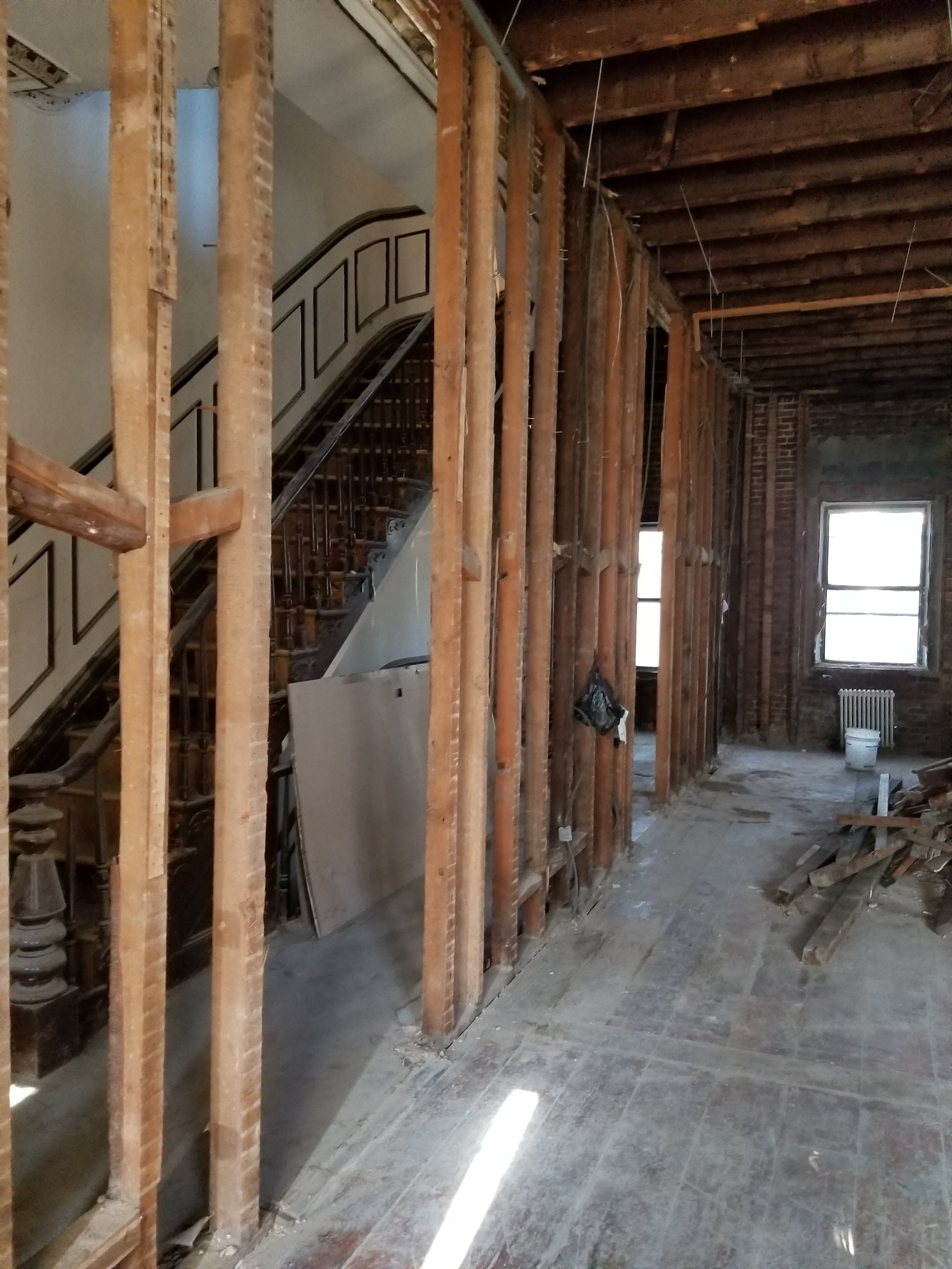

The interior structural work is officially underway!

279 Sackett Sep18-01.jpg

December 11, 2018

As you remember from our last update, the DOB examiner at 279 Sackett Street requested that we install a sprinkler system throughout the building.  However, sprinklers have not been required in similar projects in the past because they are already supplemented by fire alarms, fire escapes, and other safety measures. Fortunately, the builder pushed back on this request and was able to get the sprinkler objection removed, allowing us to move into the final stage of DOB permit approval.

At our most recent DOB meeting, the examiner requested we conduct a special underpinning report to test the adjacent neighbors’ foundations. The underpinning report will confirm exactly where and how deep we need to underpin the neighbors’ foundations with suring supports when we do our rear extension. Our structural engineer is finalizing the report now. We have a follow up meeting scheduled with the DOB next week. If all goes well, we expect to receive full approvals after 1-2 more meetings!

BrooklynMatthew Callahan
